Simulate what you cannot yet measure: the electricity demand of road tunnels

A tunnel's operator rarely has detailed load measurements, especially at the design stage. The Tunnel Load Simulator builds the demand from what is known about the tunnel, says how uncertain it is, and states its limits.

Haytham El-Houari and Cyril Voyant · SmartTunnel project, Université Sidi Mohamed Ben Abdellah (Fès) and Mines Paris – PSL

In brief

The finding

Where a tunnel has no measurements yet, no model can be trained or validated for it, but a great deal can be simulated. A simple model, whose every coefficient is visible, gives credible orders of magnitude, their variability, and the effect of each design choice, provided its assumptions are stated.

The question

How much electricity does a road tunnel use, hour by hour, and how uncertain is that figure? The answer matters for sizing connections, choosing lighting and ventilation technologies, or studying local energy storage. Measured series are rare and site-specific.

The theory, in plain words

The power drawn at each moment is the sum of four parts, plus a small random fluctuation:

Each year is simulated many times with different random draws (Monte Carlo). The result is a median and a P10–P90 band, rather than a single curve.

Where it sits on the complexity ladder

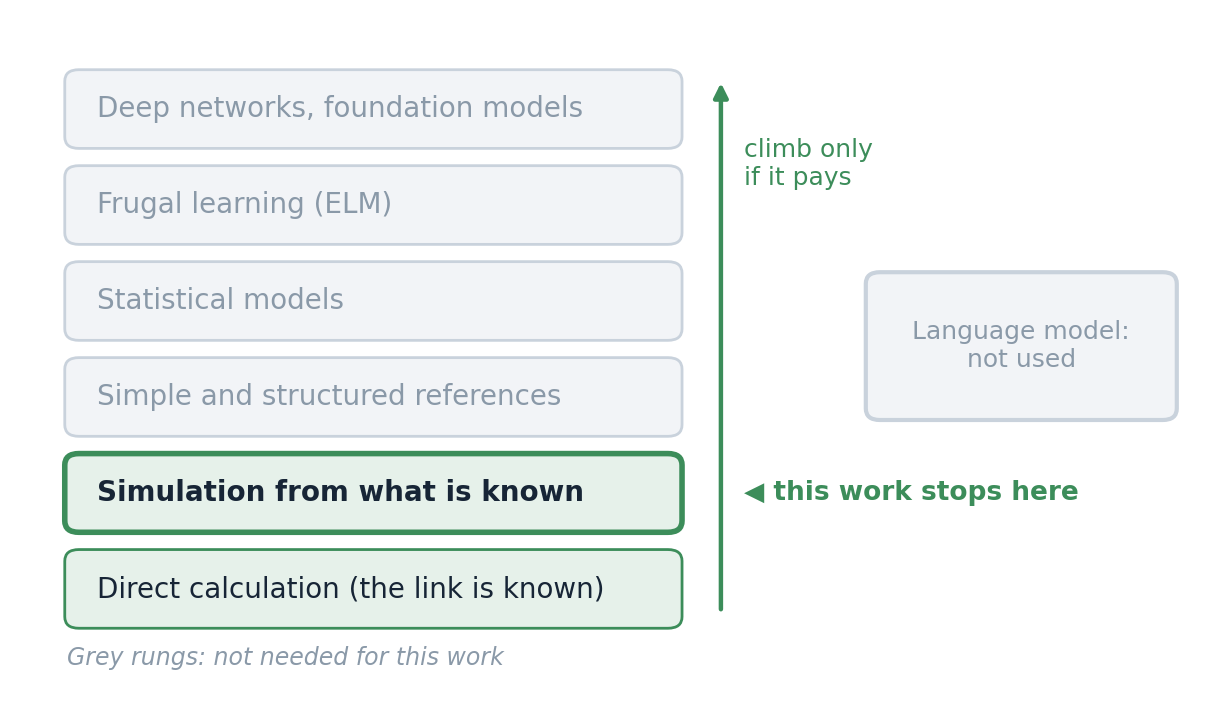

Complexity ladder: the simulator stops at the second rung, simulation from what is known
Complexity ladder: the simulator stops at the second rung, simulation from what is known

Second rung: simulation from what is known. Without local measurements, nothing can be calibrated or validated for this tunnel, and nothing is pretended: the parameters are engineering orders of magnitude, shown and adjustable.

The example in figures

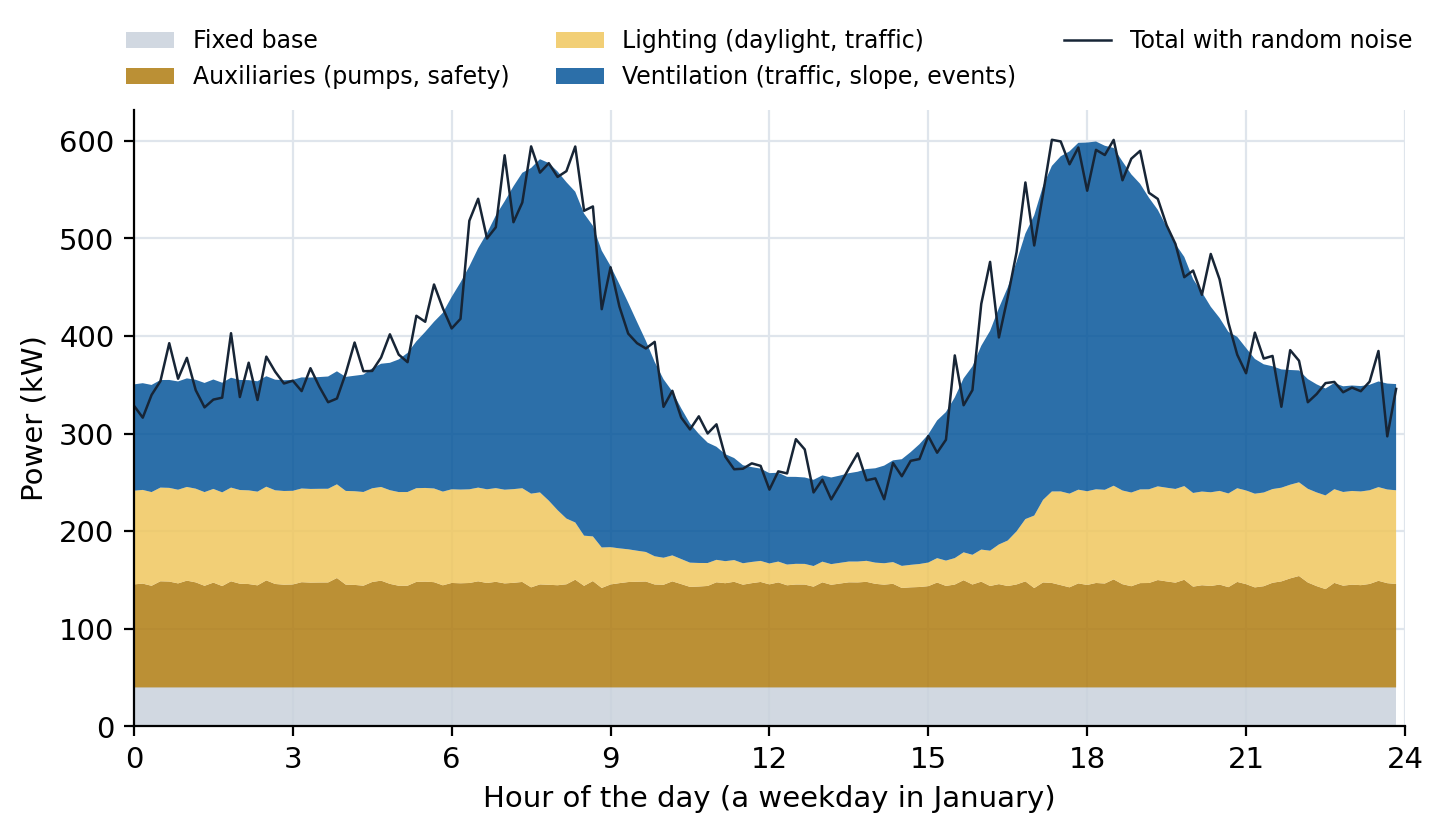

One weekday: fixed base, auxiliaries, lighting and ventilation stacked
One weekday: fixed base, auxiliaries, lighting and ventilation stacked

On a January weekday, ventilation carries the two traffic peaks; lighting rises at night and at the edges of the day.

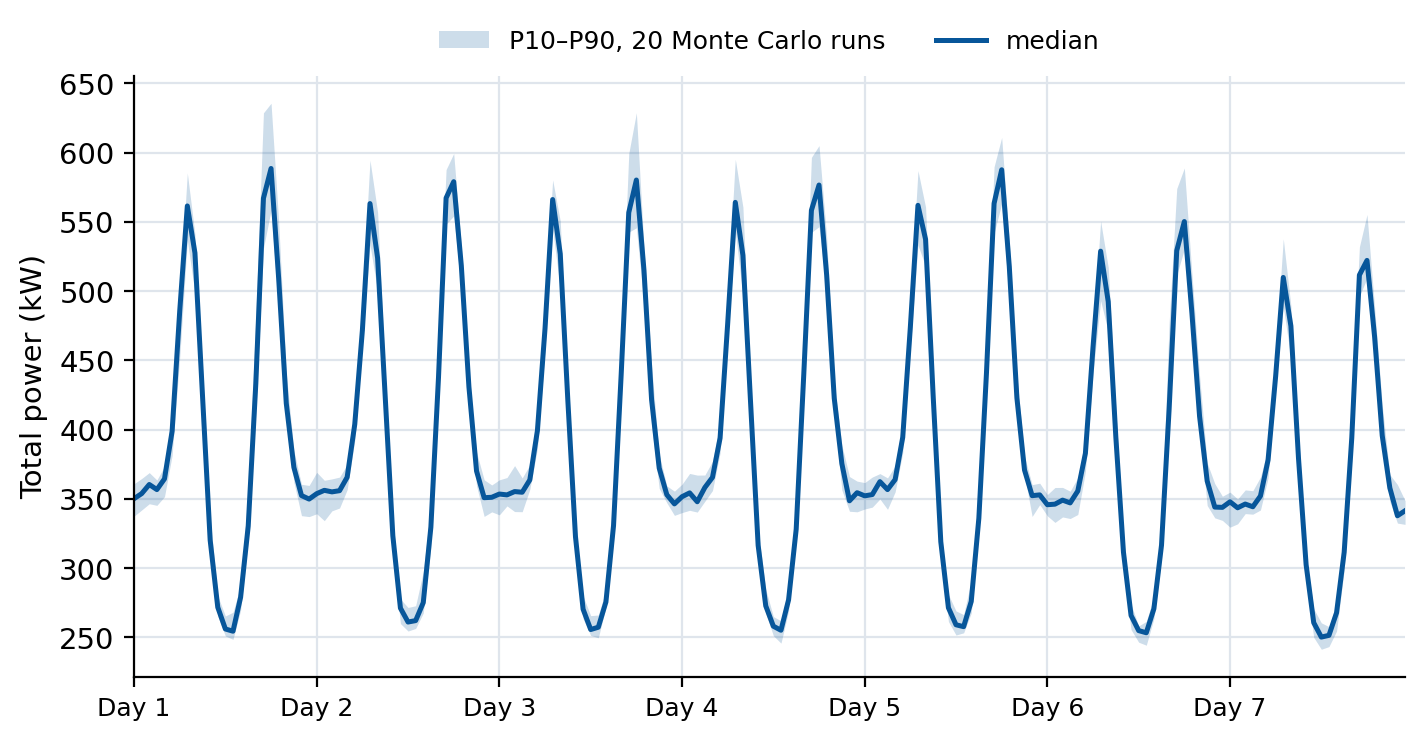

One week: median and P10–P90 band over 20 runs
One week: median and P10–P90 band over 20 runs

Over a year, the 1.5 km tunnel of the public example gives:

What it brings, and its limits
